Every autumn, food production sites and manufacturing plants across the UK scale up. Extra lines open, shift patterns extend, and headcount can climb by a third within weeks. Meanwhile, capacity for temporary worker training stays exactly where it was, and so do the systems that verify competence.
That mismatch is the real problem with temporary worker training, and it is rarely a recruitment failure. The people get hired. What breaks is the ability to answer a much harder question on any given shift: can this site demonstrate that the person running the line is currently competent to do it?
This article covers why temporary worker training breaks when a workforce scales faster than verification can follow, what UK regulation and food safety standards actually require, and how to fix it before the ramp rather than during it.
Why temporary worker training breaks when a workforce scales
The scale of temporary work in the UK is significant. Around 872,000 temporary or contract workers were on assignment on any given day in 2024, according to the Recruitment and Employment Confederation (REC, 2025).
However, the more revealing figure sits alongside it. The average assignment fell to 18 weeks in 2024, down from 22 weeks the previous year (REC, 2025). Induction and verification are a largely fixed cost per worker. A shorter assignment therefore recovers that cost over less productive time. Consequently, the pressure to compress induction rises at exactly the moment the number of inductions rises. Peak season shortcuts are therefore not carelessness. They are arithmetic.
Four failures a completion report will not show you
As a result, seasonal staff training tends to fail in four recognisable ways:
- Returners are treated as strangers. Most systems archive or delete leavers, so last season’s trained workers re-enter as new starters. The site pays the induction cost twice on the same person and discards evidence it already generated.
- Procedures move on, records do not. Peak is when SOPs change most. A returner’s record says “trained.” It does not say “trained on version three while version five is running.”
- Supervision thins without a decision. Adding 40% to headcount does not add 40% to supervisors. Sites monitor completion percentages closely and supervision ratios almost never, despite supervision being the control that compensates for shallow experience.

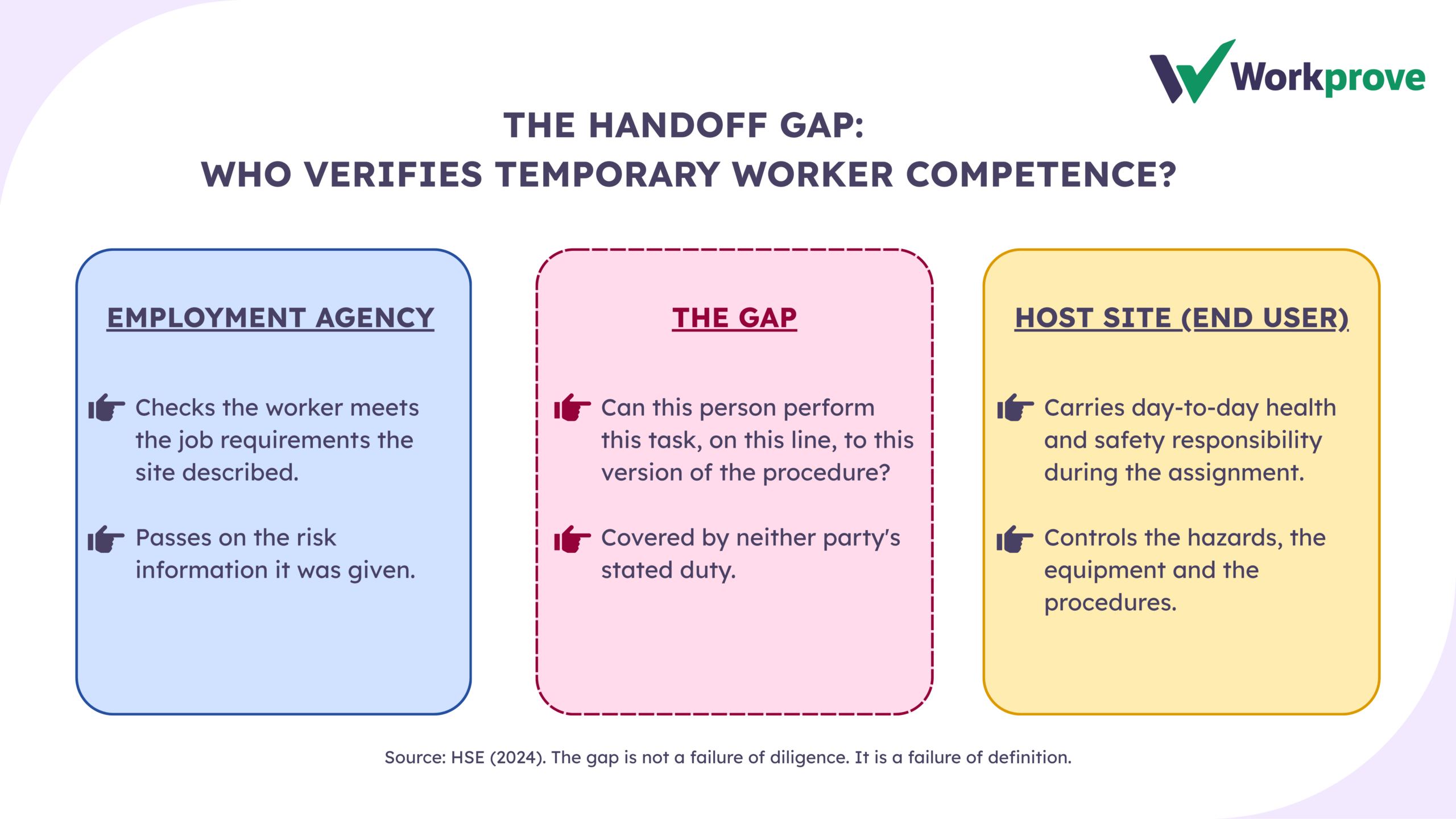

- Agency records stay with the agency. The site holds an assurance rather than a record. During an audit, an assurance is not evidence.
Where the pressure lands hardest
The pattern is consistent, but what has to be proved differs by sector.
| Sector | What drives the surge | The record that has to hold |
|---|---|---|
| Food and beverage production | Christmas and seasonal SKU runs, extended shifts | Allergen awareness for agency and temporary staff, tied to the current allergen matrix |
| Manufacturing | Order surges and additional line capacity | Site authorisation for plant and equipment, separate from the external licence |
| Transport and logistics | Peak parcel and grocery volumes across extended night shifts | Manual handling and MHE authorisation verified at the zone, not the classroom |
| Health and social care | Winter pressures met through bank and agency staff | Mandatory training and safeguarding currency, evidenced by the provider rather than the agency |
Temporary worker training in each of these sectors fails for the same structural reason, even though the standard being audited against changes.
Underneath all four sits the same substitution, and it is the reason temporary worker training needs treating differently from permanent induction. Training completion is an input. Competence is an outcome. For permanent staff, tenure quietly absorbs the difference through daily supervision and repeated exposure. Temporary worker training has no such buffer, because a worker on a 12-week assignment may never be observed performing the task after initial sign-off.
